Control Room Video Wall Solutions for System Integrators

2026-08-08

A control room video wall runs different rules than an office display. It doesn't power off at 6pm, it can't drop a camera feed mid-shift, and the cable routing behind it has to survive a project acceptance inspection, not just look tidy on delivery day. If you're a system integrator or engineering contractor speccing a 24/7 monitoring wall, here's what actually needs to be right before you sign off on a supplier.

control room video wall installation in 24/7 command center

Which Control Room Profile Matches Your Project

Control room video wall requirements shift depending on who's staring at the screen and what they're deciding from it. These four profiles cover most of the projects we quote, and each one changes the spec sheet in a specific way.

Security & Public Safety Command Centers

Operators monitor dozens of camera feeds in rotating shifts, often within 2 meters of the wall. Bezel width and signal switching speed matter more here than anywhere else on this list.

Traffic Dispatch Control Rooms

High feed count, real-time incident response, frequent full-screen and split-screen switching. Matrix processor throughput becomes the bottleneck if under-specced.

Smart City & Utility Operations Centers

Mixed data sources: GIS mapping, IoT sensor dashboards, live feeds. Wide color gamut and consistent brightness across a large array matter for readability across data types.

Enterprise & Industrial Monitoring Rooms

Usually smaller arrays, tighter budgets, but the same 24/7 duty cycle requirement as a government command center. Don't let the smaller scope justify cutting panel grade.

Not sure which profile fits? Send your room layout and camera/feed count and we'll tell you the right configuration. Get a project assessment →

The Parameters That Aren't Optional in a 24/7 Room

A lot of video wall video wall quotes look similar on paper until you check what's actually driving the price. In a control room, four things aren't negotiable no matter what the budget line says.

Duty Cycle and Panel Grade

Commercial-grade LCD panels are built for 8-12 hours of daily use. Push them to 24/7 monitoring control room video wall duty and backlight failure shows up early, often inside the first 18 months. Industrial-grade panels rated for continuous operation carry a meaningfully higher MTBF and are the only grade we'll quote for a room that never powers down.

60,000 hrsMTBF, industrial-grade panel
6–7 yrsContinuous 24/7 runtime before failure risk climbs
±0.1mmMounting tolerance, close-viewing arrays
2–3 yrsStandard project warranty

Bezel Width vs. Operator Viewing Distance

Control room operators sit closer to the wall than almost any other video wall use case, which is exactly where bezel width stops being cosmetic and starts affecting whether a camera feed reads clearly across a panel joint. For sub-2-meter viewing, we spec 0.88mm as standard, not an upsell. For rooms with operators further back, 1.7mm holds up fine and costs less.

See the full breakdown of bezel grades and calibration tolerances: seamless control room video wall specifications

Signal Integration and Matrix Switching

This is where a lot of quotes fall apart in practice. A control room wall needs to take in NVR outputs, IP camera streams, workstation feeds, and sometimes SCADA or GIS software, then switch or window them without a visible hitch. The matrix processor's channel count and switching latency matter more than the panel spec once you're running 20+ camera feeds with PIP/POP windowing. Under-speccing the processor to save budget on a project is the single most common mistake we see integrators inherit from a previous vendor.

Power and Cooling Redundancy

A wall running continuously needs airflow clearance behind the array, typically a minimum of 10cm, and a power circuit rated for sustained draw rather than peak load. Skipping redundant power planning on a government or utility project is a common reason installs fail acceptance review after the fact rather than before.

Cable Management and Engineering Acceptance Standards

This is the section most video wall suppliers skip, and it's usually where control room projects actually stall out at handover. A wall that looks fine on delivery day can still fail a formal acceptance inspection if the wiring behind it doesn't meet project standards.

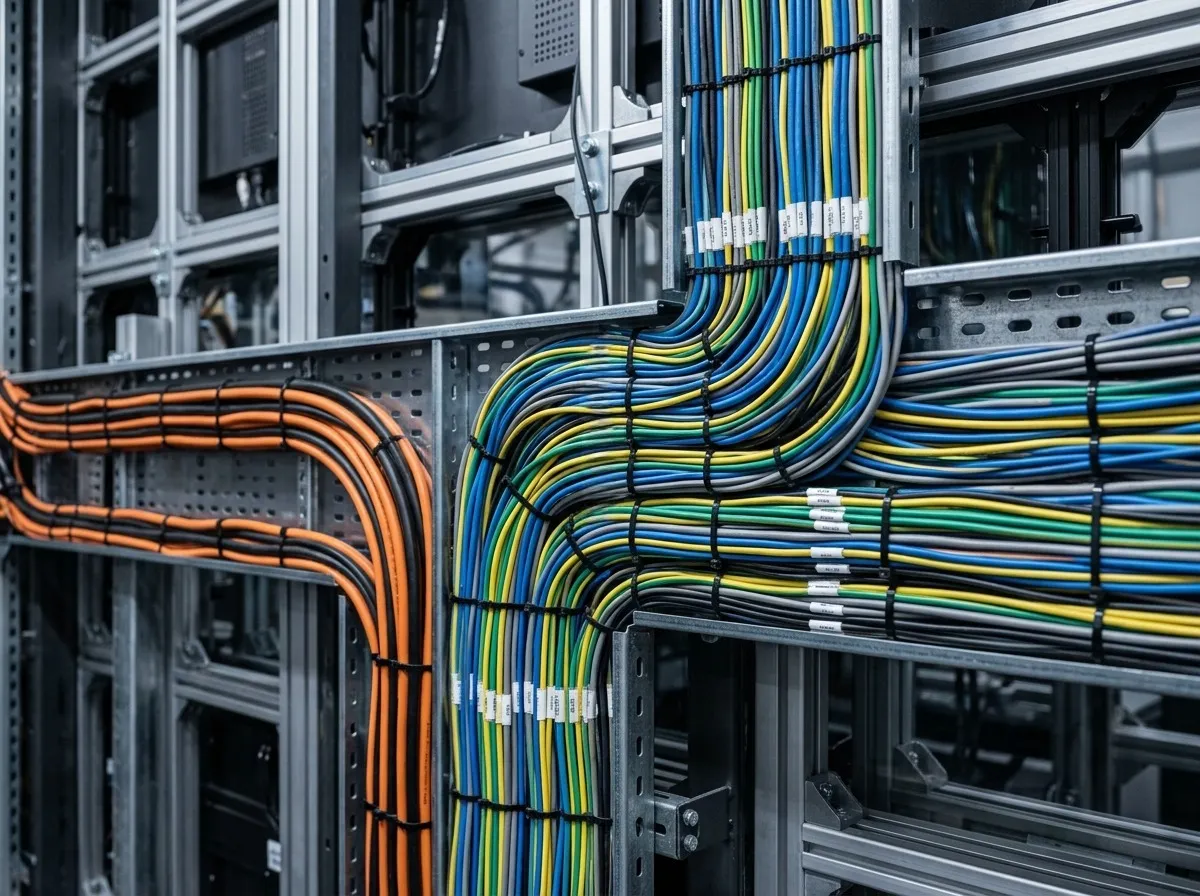

video wall cable management for control room engineering
  • Strong and weak current lines physically separated, not just bundled apart
  • All cable runs labeled and documented, matched to as-built drawings
  • Rear-mounted cable trays or channels, no exposed or loose runs
  • Load-bearing calculation submitted for wall/rack mount before install, not after
  • Commissioning checklist signed off: signal switching test, PIP/POP windowing test, color calibration record

Government and utility projects in particular often require documentation alongside the physical work: as-built cable diagrams, load calculations, and a signed commissioning report. Suppliers who only sell hardware leave the contractor to assemble this paperwork after the fact, usually under deadline pressure right before inspection. We handle documentation as part of the install scope specifically because we've seen projects held up at handover over missing paperwork, not missing hardware.

Need your acceptance documentation format matched to a specific project standard? Tell us the requirement and we'll confirm before install starts. Discuss project documentation →

Real Project: 3x4 Control Room Video Wall for a Traffic Dispatch Center

A traffic dispatch center needed to replace an aging wall that had two dead panels and color drift bad enough that dispatchers were manually adjusting their own monitors to compensate during shift handover. The room ran three shifts, so downtime for the swap had to stay under a few hours per night.

Application24/7 traffic dispatch, close-range operator viewing Configuration3x4 array, 46" panels Bezel0.88mm Panel gradeIndustrial, 60,000hr MTBF Signal input18-channel matrix, NVR + workstation feeds Timeline4 nights, phased install

Two things drove the spec here. Operators sit under two meters from the wall for full shifts, which put us at 0.88mm bezel without much debate. And the room runs 18 separate camera and workstation feeds through PIP/POP windowing during incident response, so the matrix processor's channel count and switching speed got as much attention in planning as the panels themselves.

Install ran across four nights instead of one continuous shutdown, since the dispatch center couldn't go dark during business hours. Cable routing followed the department's existing as-built documentation standard, with strong/weak current separation and labeled runs matched to their format so the project cleared acceptance review on the first inspection.

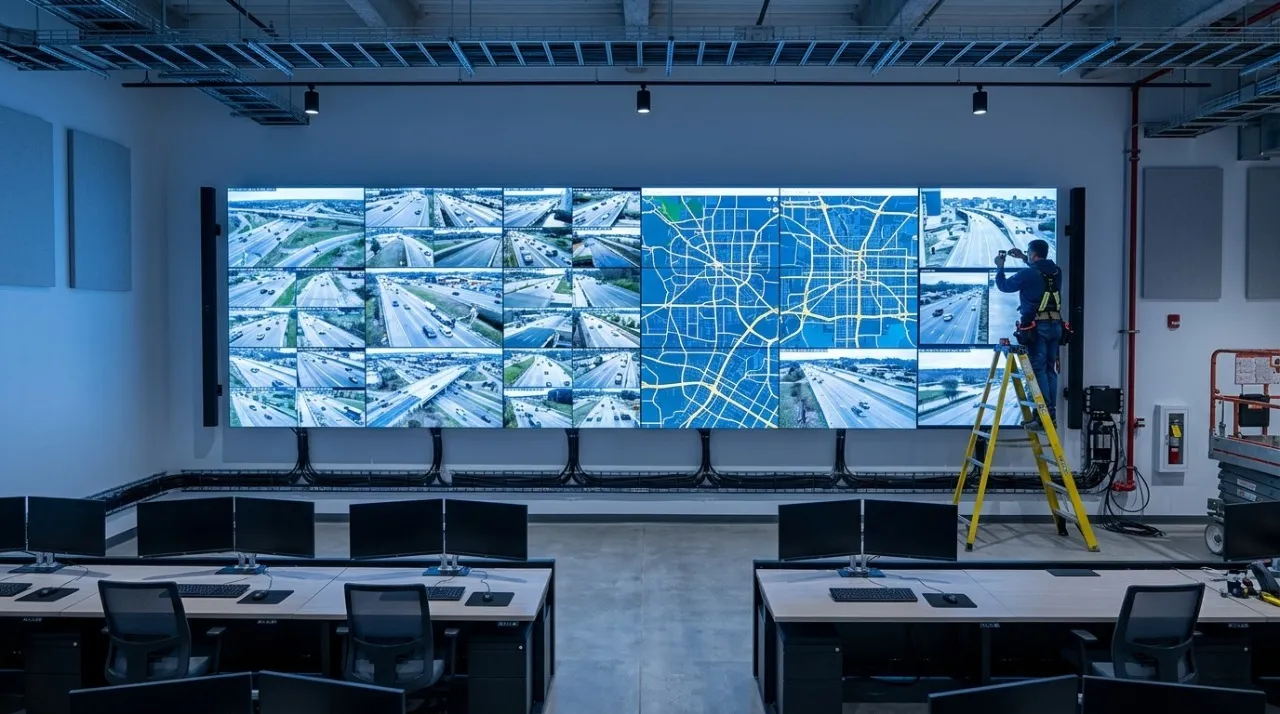

24/7 control room video wall installation traffic dispatch center
"The last vendor left us with a wiring closet nobody wanted to open. This time the as-built drawings matched what was actually behind the wall, and we passed inspection without a punch list." — Project Engineer, Municipal Traffic Dispatch Center (client name withheld per site policy)

Why the Manufacturer Behind the Install Matters

A control room video wall manufacturer that also runs the install crew and stocks spare panels locally solves a problem that a hardware-only reseller can't: when a panel fails at 2am in a 24/7 room, you need a replacement and a technician, not a support ticket routed through three time zones. Before committing to a supplier for a control room project, confirm they own production (not reselling mixed batches from different factories, which causes the color drift problem this whole page keeps coming back to), can produce certification documentation, and stock spares domestically rather than on a six-week import cycle.

Factory & Certification

See production line and quality documents.

Control room video wall manufacturer profile

Custom Configuration

Matrix size, bezel grade, signal processor specced to your room.

Configure your control room wall

Engineering Support

Cable management, load calculations, commissioning documentation.

Control room engineering guidelines

Frequently Asked Questions

How is a control room video wall quoted, per panel or per project?

We quote per project once we have room dimensions, matrix size, bezel grade, and signal input requirements, since installation, cable management, and matrix processor costs vary enough that a flat per-panel number is misleading. Send your specs for an itemized quote.

Can you support government or utility tender and bidding documentation?

Yes, we regularly supply technical datasheets, certification documents, and compliance statements formatted for tender submissions. Let us know the tender requirements and we'll prepare the documentation alongside the quote.

What's the typical timeline for a large-scale control room installation?

A 3x4 to 4x4 array with full commissioning typically runs 3-5 days on-site, longer for rooms that require phased overnight installation to avoid shutting down live operations.

Do you handle cable management and commissioning as part of the installation?

Yes, cable routing, strong/weak current separation, load documentation, and signal commissioning are included in our installation scope, not billed as a separate add-on.

What after-sales support is available for a room that runs 24/7?

Standard project warranty runs 2-3 years with spare parts stocked for immediate replacement. For continuous-operation rooms we recommend confirming spare panel stock and response time commitments before signing off on a supplier.

Get a Control Room Video Wall Quote and Engineering Plan

Send your room layout, feed count, and viewing distance. We'll return a configuration, itemized quote, and installation timeline within 24 hours, including documentation for tender submission if needed.

Request a Quote →
